Facility and Community Park Improvements
Current & Ongoing

Casablanca Waterfront Park Design and Construction

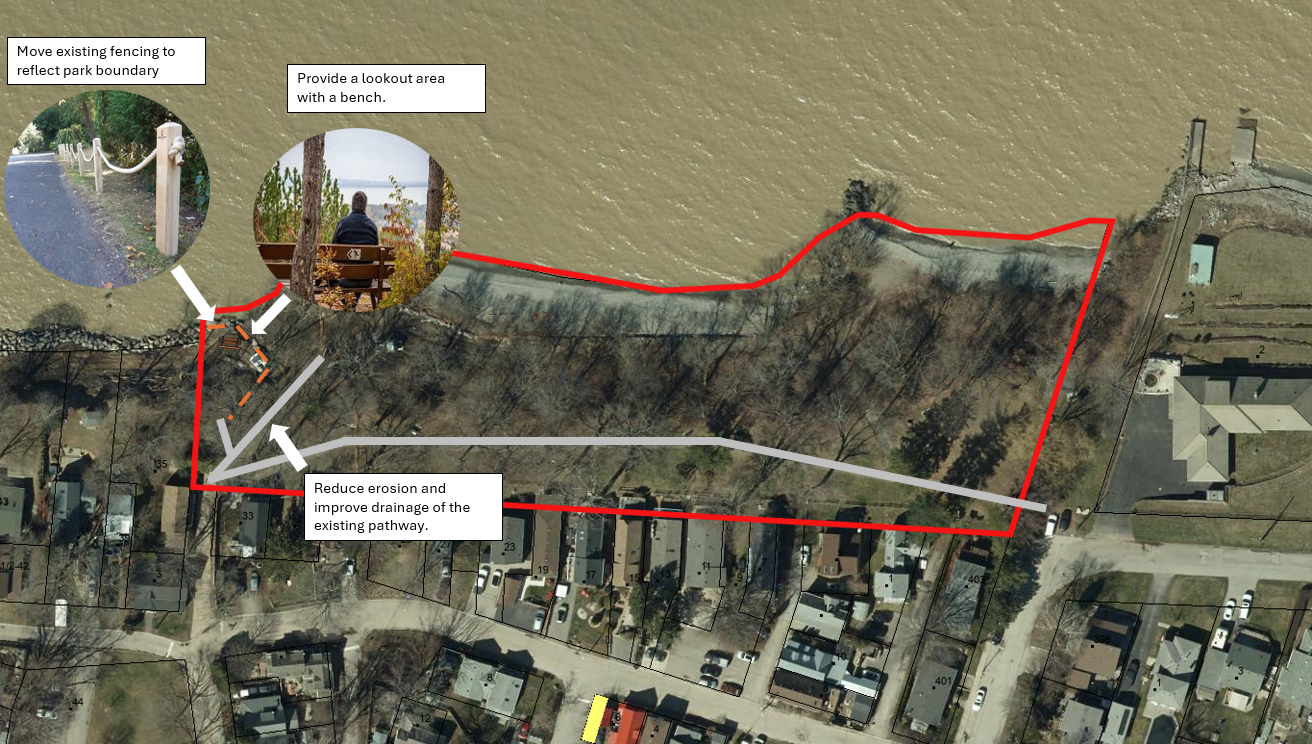

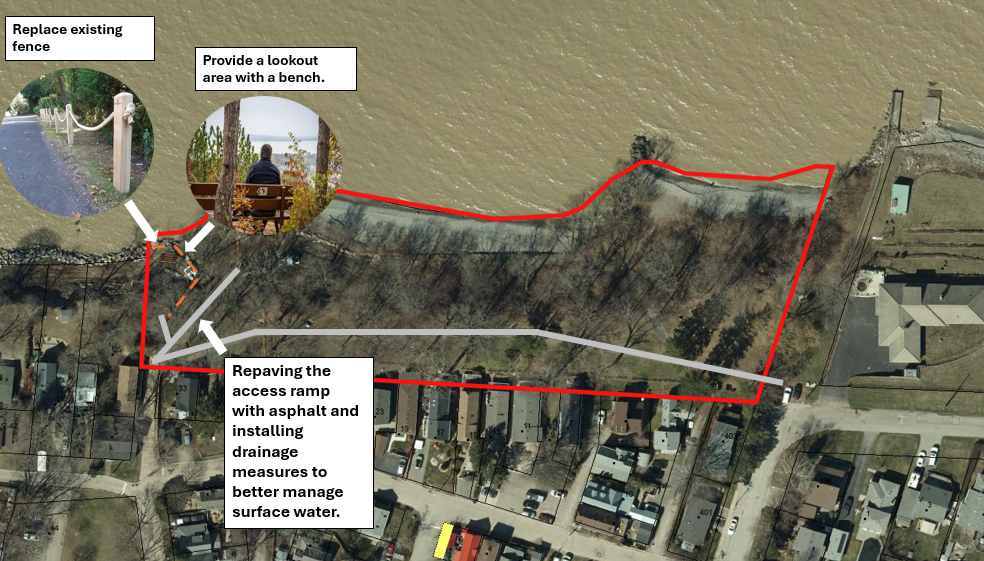

The Town of Grimsby is excited to proceed with the Casablanca Waterfront park development. Since the beginning of the development, there has been significant interest in this area. The connectivity and accessibility along the waterfront are a top priority for the Casablanca neighbourhood. In addition, developing this area to allow for better movement and higher community involvement will subsequently benefit local residents. The Casablanca Waterfront Project is a project that all Grimsby residents can enjoy; the vision is to develop the community park and promote the area as a destination park.
The Casablanca Waterfront Project spans the waterfront area from Hunter Road to the Water Treatment plant (with the easterly Losani development area to be developed later). The park project will be completed in several phases to maintain community access to the waterfront pathway as much as possible throughout the process.
Timeline of Work
Site Analysis and Program Development
- May 2021 - June 2021
- Complete
Conceptual Design Development
- June 2021 - September 2021
- Complete
Round Two of Community Engagement
- October 2021 - November 2021
- Complete
Detailed Design and Costing
- December 2021 - March 2022
- Complete
Detailed Design Approvals
- March 2022 - June 2022
- Complete
Procurement and Project Tendering
- June 2022 - September 2022
- Canceled
- May 2023 - July 2023
- Complete
Park Construction of Phase One, Two and Three
- Summer 2023 - Spring 2024
- In Progress
Project Website
www.letstalkgrimsby.ca/casablanca-waterfront-project

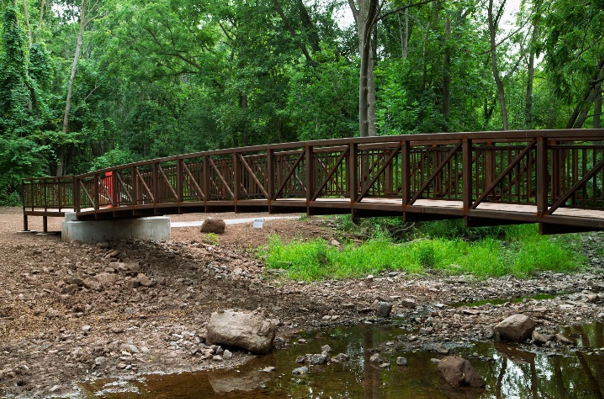

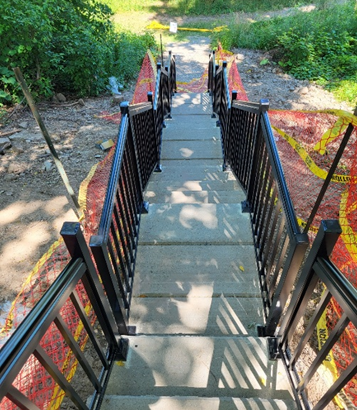

Forty Mile Creek Pedestrian Bridge Replacement
The current Forty Mile Creek pedestrian bridge is a wooden bridge that crosses Forty Mile Creek. The bridge was constructed using materials such as old telephone poles through a community partnership as part of a Bruce Trail connection. The community worked together to build the bridge, which held up for many years! Unfortunately, the bridge was closed in previous years due to safety concerns with the structure. Work is in motion for removing and replacing the Forty Mile Creek Bridge; a timeline is provided below.
Timeline of Work
Procurement for Engineering Design
- June 2022 - September 2022
- Complete
Design Work for Bridge Replacement
- September 2022 - January 2023
- Complete
Council Presentation of Design
Budget Approval (Removal and Replacement)
Construction Documentation and Detailed Drawings
- May 2023 - August 2023
- Complete
Procurement Process for Construction Work
- August 2023 - September 2023
- Complete
Budget Amendment Request
- October 11th Finance Meeting
- Complete
- October 16 Council Meeting
- Deferred
Construction Period for Removal and Replacement
- To Be Determined
- Deferred

Grand Oak Park

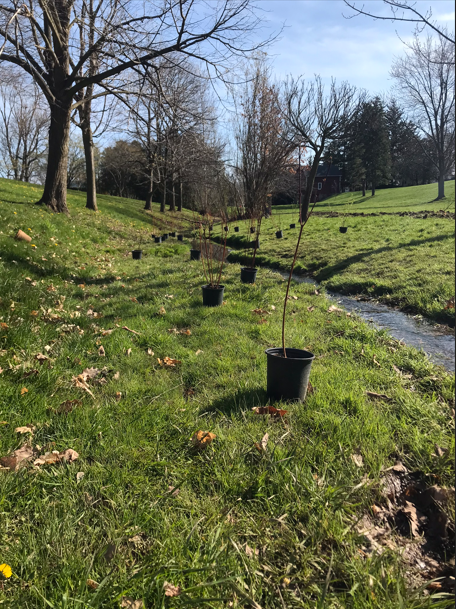

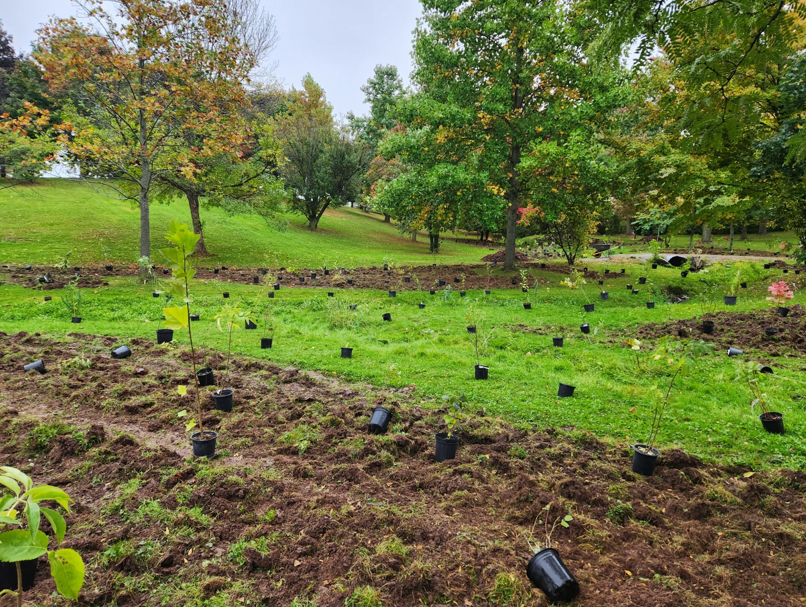

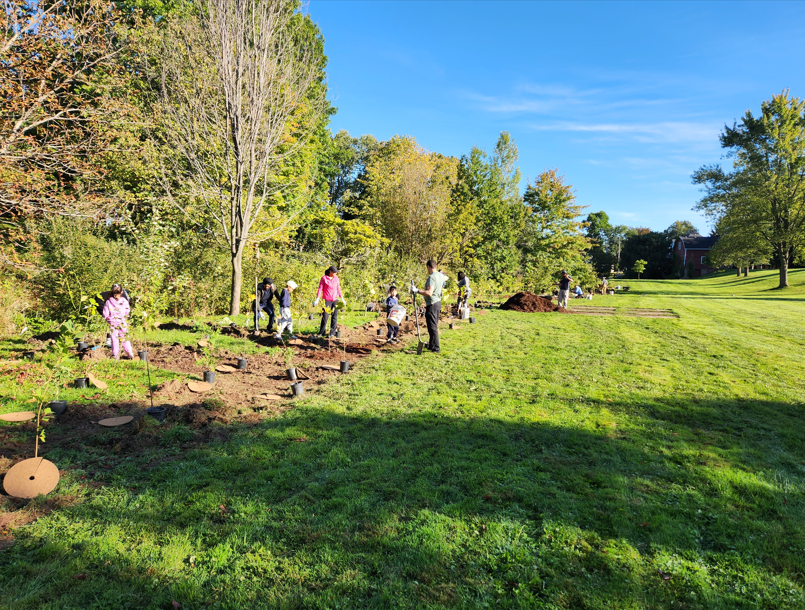

Work is being undertaken at the park to build on what was already done by local citizens to plant native species. In preparation for creating a butterfly garden, invasive species, such as Japanese Knotweed, Multiflora Rose and Black Locust, are being controlled physically and chemically to make way for new plantings. This will support biodiversity and make the park more beautiful and educational for visitors.
Timeline of Work
Removal of Invasive Plants through the use of Spray and Machine
- Fall 2022 and Spring 2023
- Complete
Cutting/Tarping/Mulching Large Oval Wildflower Garden
Design Plans for Wildflower Garden
- Winter/Spring 2023
- Complete
Plant Small Round Wildflower Garden
Peach King Centre Expansion and Renovation
In 2019, a citizen-driven Parks, Recreation and Culture Master Plan identified the need to improve opportunities for community recreation and access to indoor facility space in Grimsby. To achieve this, one of the top recommendations was to work towards a multi-use recreation facility on the Peach King Centre Grounds. This goal was further supported by Town Council's Strategic Priorities for 2019-22, identifying the need to "provide adequate and quality amenities to serve Grimsby's growing population."
In late August 2019, federal and provincial funding opportunities were announced and Council approved an expedited preparation of a concept plan for a Peach King Centre Expansion. On July 8th 2021, the project was selected for approval through the Ontario Government's Strategic Priorities Infrastructure Fund (SPIF), with the province contributing a grant of $16 million towards the total project cost of $21 Million. The Town of Grimsby is responsible for funding the remain $5.84 million and all facility operating costs.
Timeline of Work
Announcement of Project Funding
Confirmed Commitment and Funding Strategy by Council
SPIF Agreement Finalized
Project Management Firm Selection
Council Presentation
Design Consultant Onboarded
- Draft Stage 1 Archaeological Assessment
- Functional Program and Site Plan
- Planning Pre-Consultation
- Spring 2023
- Complete
Schematic Design
- Award of Construction Manager
- Capital Campaign Proposal and Ideas
- Summer 2023
- On Track
Project Website
www.letstalkgrimsby.ca/grimsby-peach-king-centre-expansion-project
Recreational Trails Master Plan
The Town of Grimsby is excited to start the development of a Town-wide Recreational Trails Master Plan. The purpose of the plan will be to prepare a long-range strategy that:
- Serves as the blueprint for trail planning, design, and implementation over the next 20 years.
- Promotes a shift to embrace the areas of natural and cultural significance Town-wide.
- Integrates trails into the future growth of the Town of Grimsby.
- Learns from past successes and lessons from the Town and other comparable municipalities; and
- Supports trail planning, design, and construction by Town staff and partners.
For this project, Trails include primarily off-road links that support walking, cycling, and other active recreation. It not only includes the Bruce Trail but also will include park pathways, trails in natural areas, hydro corridors and long rail connections, pathway access to the waterfront, and multi-use pathways in place of a sidewalk. The plan is not meant to address active transportation routes and facilities found on-road such as bike lanes but may connect to some of these previously identified or exiting links.
Timeline of Work
Project Initiation & Preliminary Outreach
- July 2021 - August 2021
- Complete
Background Review, Data Collection & Analysis
- August 2021 - September 2021
- Complete
Community Consultation #1
- October 2021 - November 2021
- Complete
Outline of Initial Recommendations
- November 2021 - April 2022
- Complete
Community Consultation #2
- April 2022 - May 2022
- Complete
Additional Scope of Work
- July 2022 - Fall 2022
- Complete
Prepare Draft and Final Report
Council Endorsement
- December 2023
- In Progress
Project Website
https://www.letstalkgrimsby.ca/grimsby-recreational-trails-plan

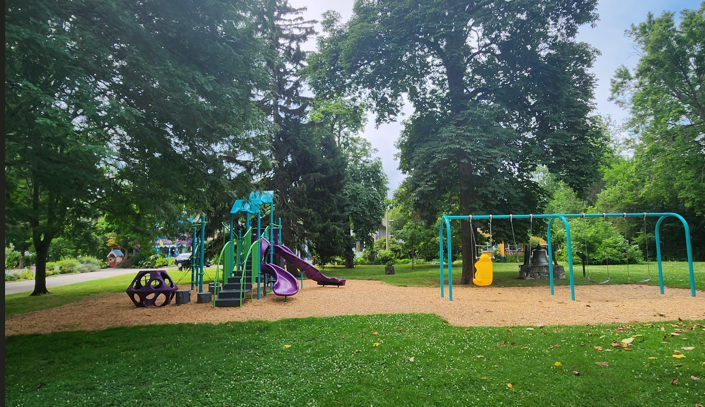

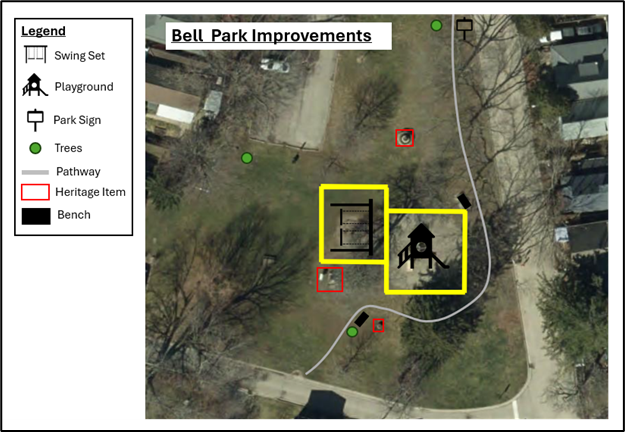

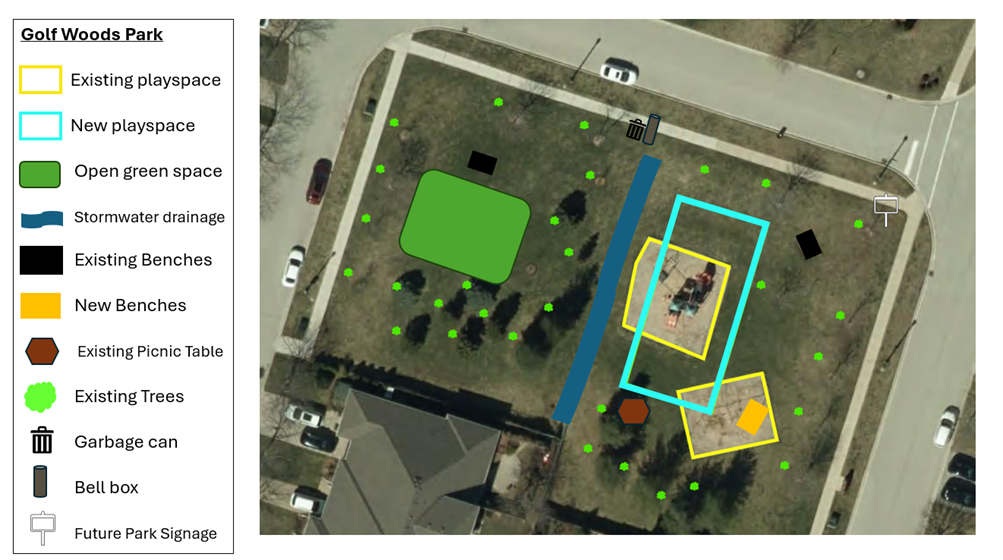

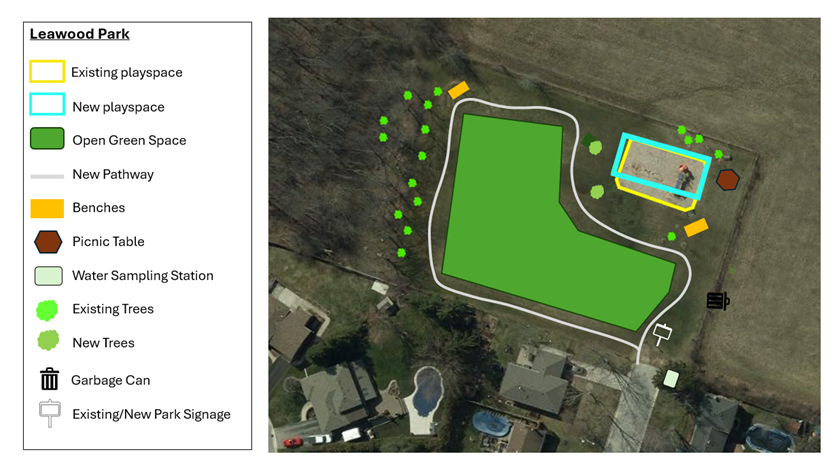

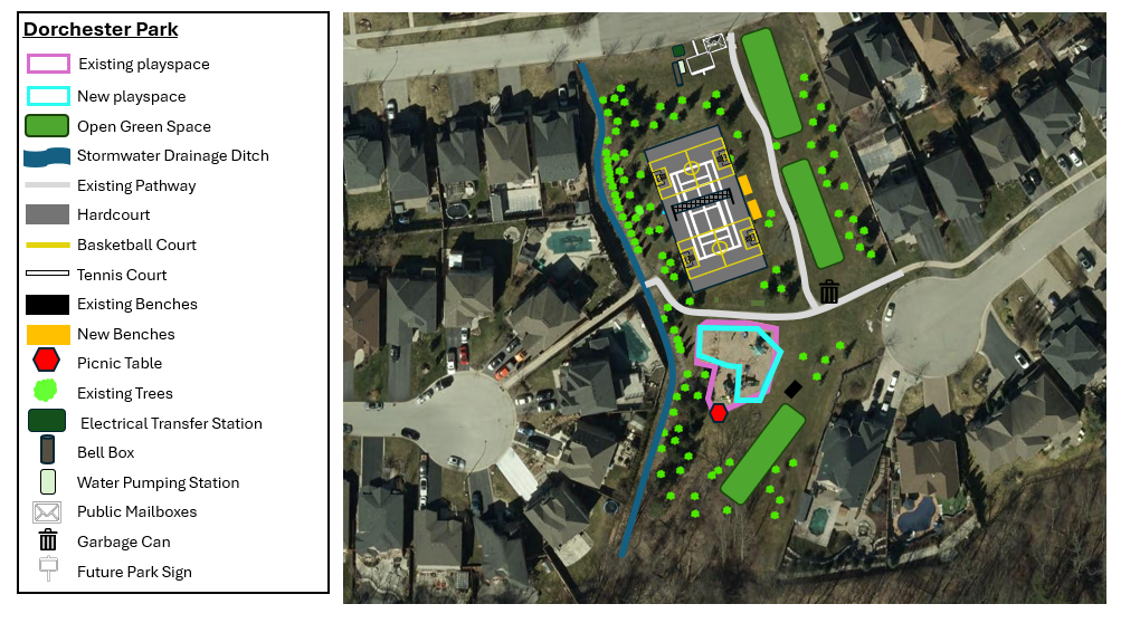

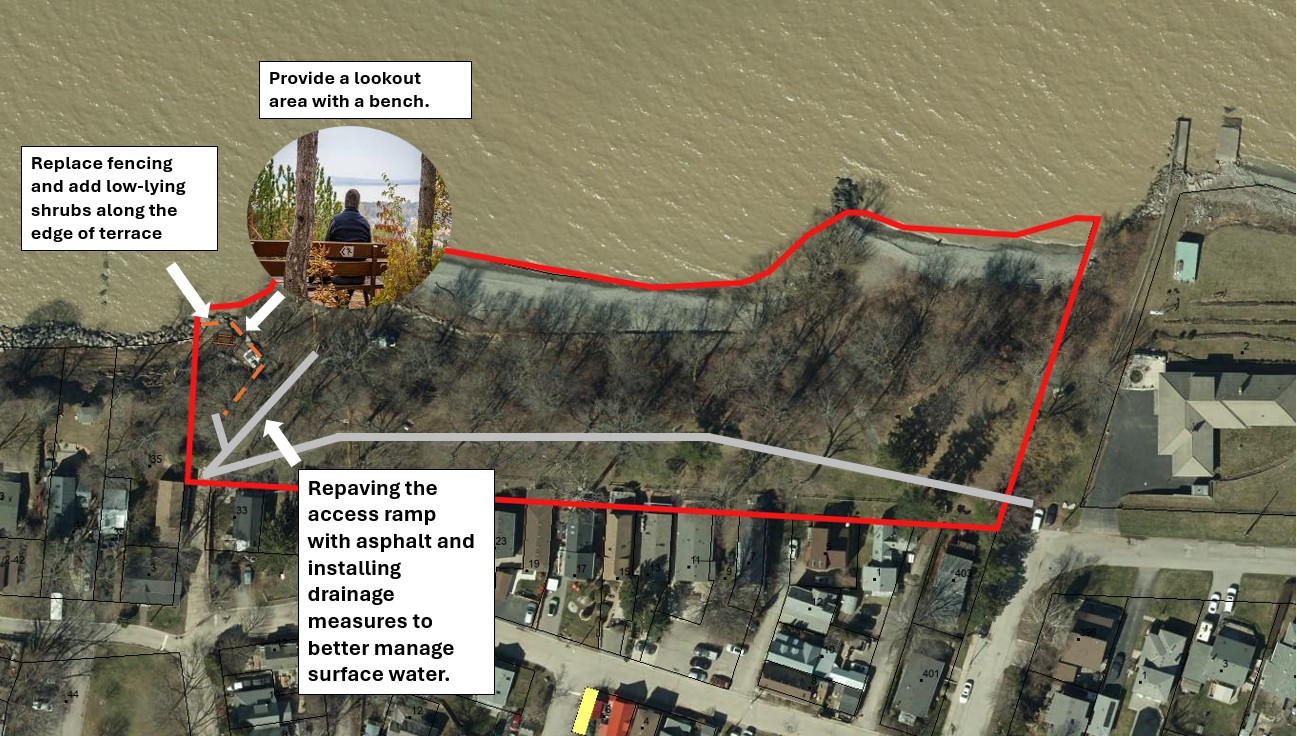

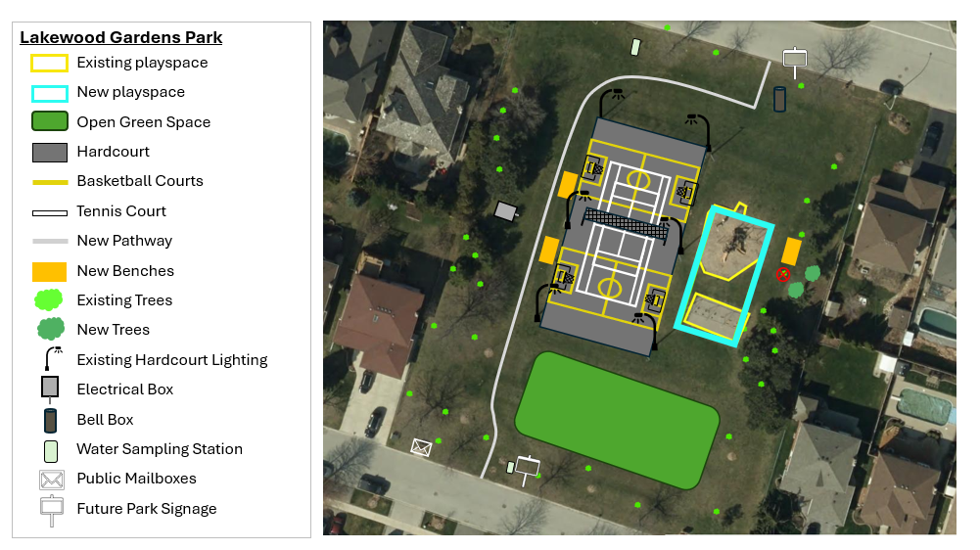

Neighbourhood Park Improvements
Gage Park
Removal of Existing Playground
Playground Structure and Swing Replacement
Dunrobin Park
Playground Structure and Swing Installation
